14 Jan 2026 Tamil Nadu Construction Market Insights

Daily Tender Updates for Engineers & Architects, Contractors I Curated by Er. Bala Vishnu Murugesan
  • All Blogs
  • Tenders
  • 14 Jan 2026 Tamil Nadu Construction Market Insights
  • 14 January 2026 by
    VM Constructions - Admin
    | No comments yet
    Today, 14 January 2026, we have curated 6 new tender notices from major newspapers.
    Key Opportunities
    • Types of Work: Major Construction Projects in Hosur (High-Rise IT Park), CMRL Phase 2 Station Architectural & Finishing Works, PWD Building Contracts (Warehouses), and SIPCOT Industrial Park Water Infrastructure.
    • Major Locations: Hosur (Krishnagiri), Chennai (Madhya Kailash, Perambur), Chengalpattu, and Kallakurichi.
    • Departments: TIDEL Park Ltd, Chennai Metro Rail Limited (CMRL), Public Works Department (PWD), Highways Department, and Southern Railway.

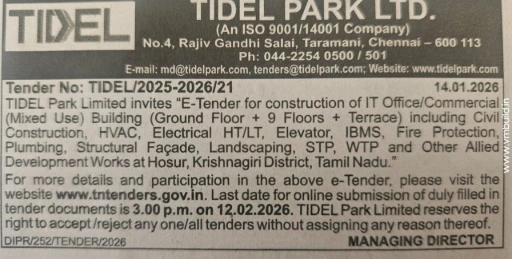

    1. Mega Project: Construction of TIDEL Park (IT/Commercial) – Hosur

    • Company: TIDEL Park (IT/Commercial)
    • Location: Hosur, Krishnagiri District.
    • Client: TIDEL Park Ltd.
    • Scope: Construction of G+9 Floors + Terrace IT Office. Includes Civil, HVAC, IBMS, Facade, and Fire Protection.
    • Deadline: 12 Feb 2026.
    • Insight: This is a multi-disciplinary project. Even if you cannot bid the main contract, look for sub-contracting opportunities in Plumbing, Electrical, and Facade works.

    • TIDEL Park Hosur construction tender notice G+9 floors IT office 2026

    Our latest content

    Check out what's new in our company !

    See all
    Your Dynamic Snippet will be displayed here... This message is displayed because you did not provide enough options to retrieve its content.

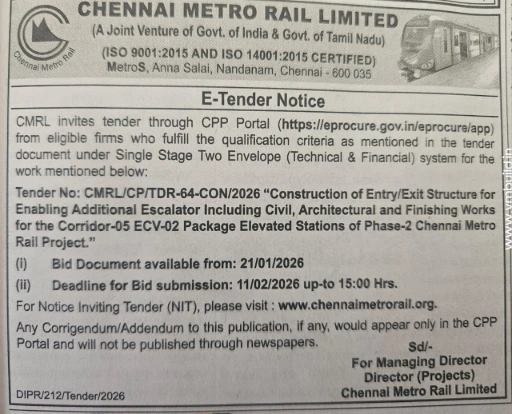

    2 Infrastructure: CMRL Phase-2 Station Entry/Exit

    • Location: Chennai Metro Phase-2 (Corridor-05).
    • Client: Chennai Metro Rail Limited (CMRL)Phase-2
    • Scope: Civil, Architectural, and Finishing Works for Entry/Exit structures and Escalator enabling.
    • Deadline: 11 Feb 2026.
    • Insight: Note the inclusion of "Architectural and Finishing." This moves beyond structural concrete into aesthetics and passenger amenities.

    • Chennai Metro Rail CMRL Phase 2 station entry exit construction tender

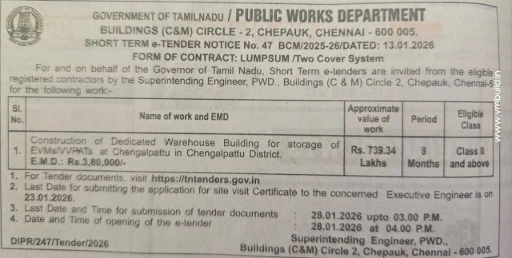

    3 Government Buildings: EVM Warehouse Construction

    • Location: Chengalpattu District.
    • Client: PWD Buildings (C&M) Circle 2.
    • Project Value: ₹7.39 Crores (approx).
    • Scope: Construction of dedicated warehouse for EVMs/VVPATs.
    • Deadline: 28 Jan 2026.
    • Class: Class II and above.
    • PWD Chengalpattu tender notice for EVM Warehouse construction value 7.39 crores

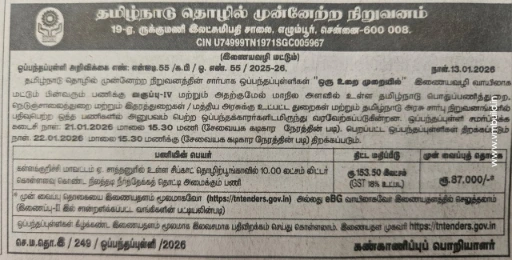

    4 Industrial Water: 10 Lakh Litre Reservoir (GLSR)

    • Location: SIPCOT Industrial Park, Kallakurichi.
    • Client: TN Industrial Guidance & Export Promotion Bureau.
    • Project Value: ₹1.53 Crores.
    • Scope: Construction of Ground Level Service Reservoir (GLSR) for water supply.
    • Deadline: 21 Jan 2026.
    • SIPCOT Kallakurichi GLSR water tank construction tender notice

    5 Urban Beautification: Madhya Kailash Flyover

    • Location: Sardar Patel Road, Chennai.
    • Client: Highways Department (Chennai Metro Development Circle).
    • Scope: Beautification work below the flyover at Madhya Kailash junction.
    • Deadline: 01 Feb 2026.
    • Insight: A great portfolio project for firms specializing in Landscape Architecture and Urban Design.

    Chennai Highways Department Madhya Kailash flyover beautification tender

    6 Maintenance: Railway Steel Structure Painting

    • Location: Perambur Carriage & Loco Works, Chennai.
    • Client: Southern Railway.
    • Value: Total approx ₹2.2 Crores (Combined).
    • Scope: Painting of steel structures (corrosion protection).
    • Deadline: 02 Feb 2026.

    Southern Railway Perambur workshop steel painting tender notice 2026
